Toll Office Project

Conceptual Drawings

  • Images 1-4

Construction Timeline

Pre Council Consent

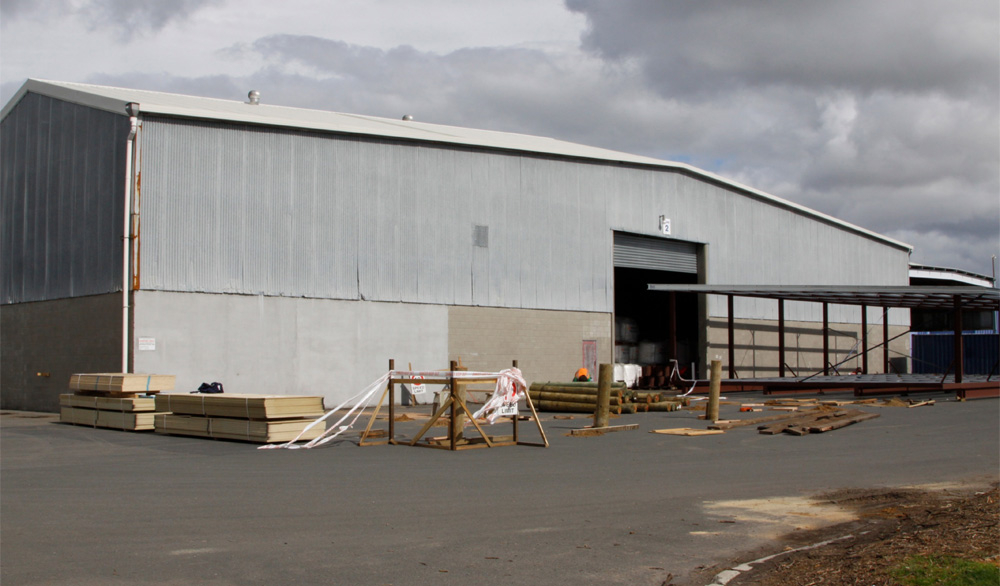

Week One

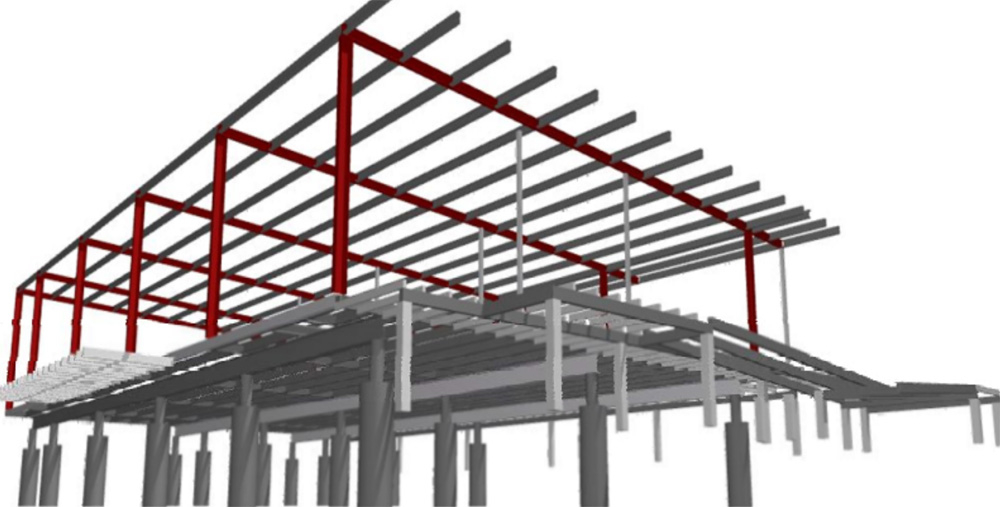

  • Steel framing arrives onsite (images 5&6)

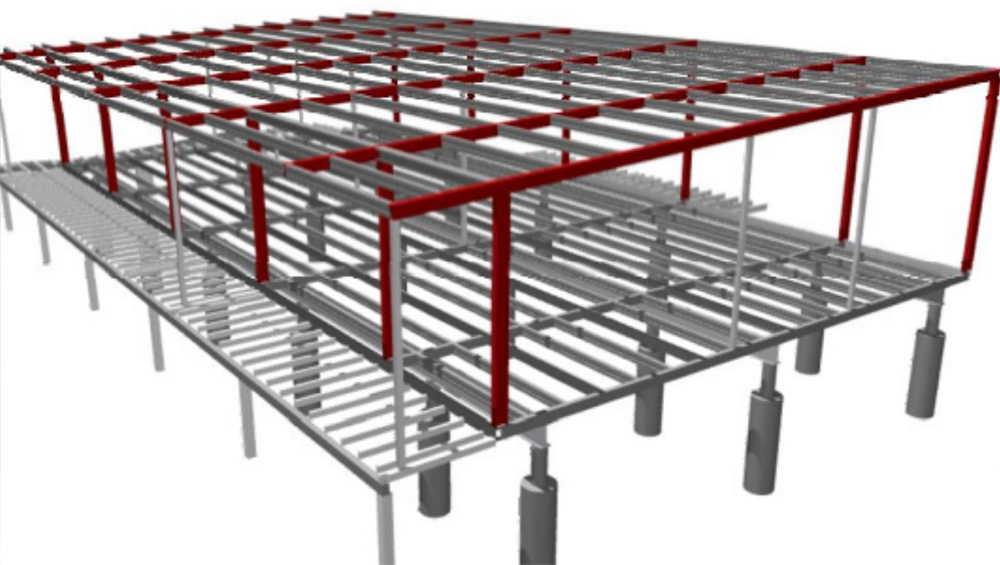

  • Roof on (image 7)

Week Two

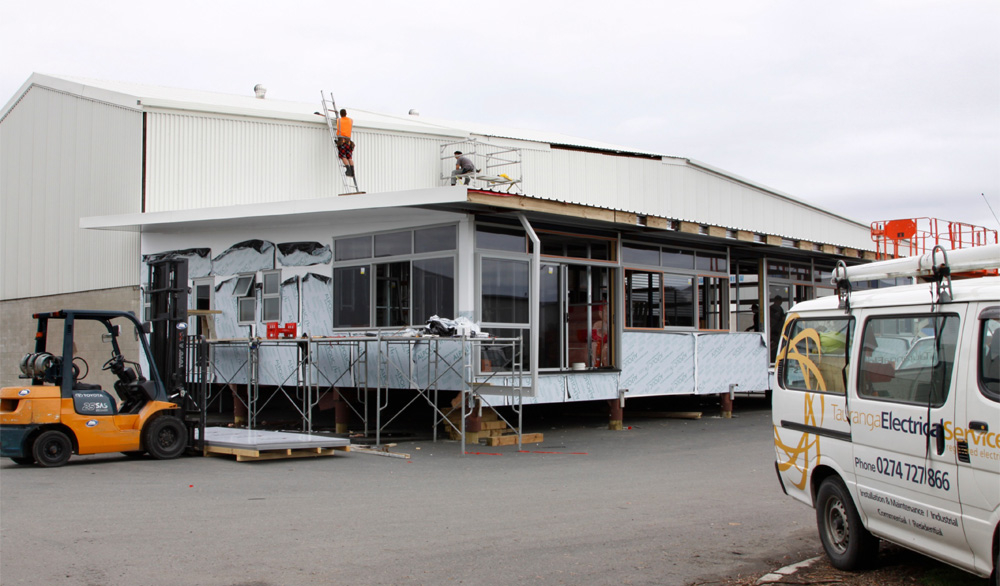

  • Piles being placed, roof on (image 8)
  • Pre-inspection of piles (image 9)
  • Window Frames added (image 10)

Post Council Consent

Week Three

  • Piles concreted, caps in place and hole for office created (image 11)
  • Two 30 tonne cranes picking up sub-structure and placing it (image 12)

Week Four

  • Building in place and being set into the commercial building (image 13)
  • Building wrapped with battons going in (image 14)
  • Interior steel framing and exterior cladding (image 15)

Week Five

  • Windows going on and exterior cladding completed (image 16)
  • Electrics and plumbing being started (image 17)
  • All electrics completed, windows in place and the building is completely secure (image 18)

Week Six

  • Interbal walls and bathrooms completed. Putting on canterlevering system for decks (image 19)

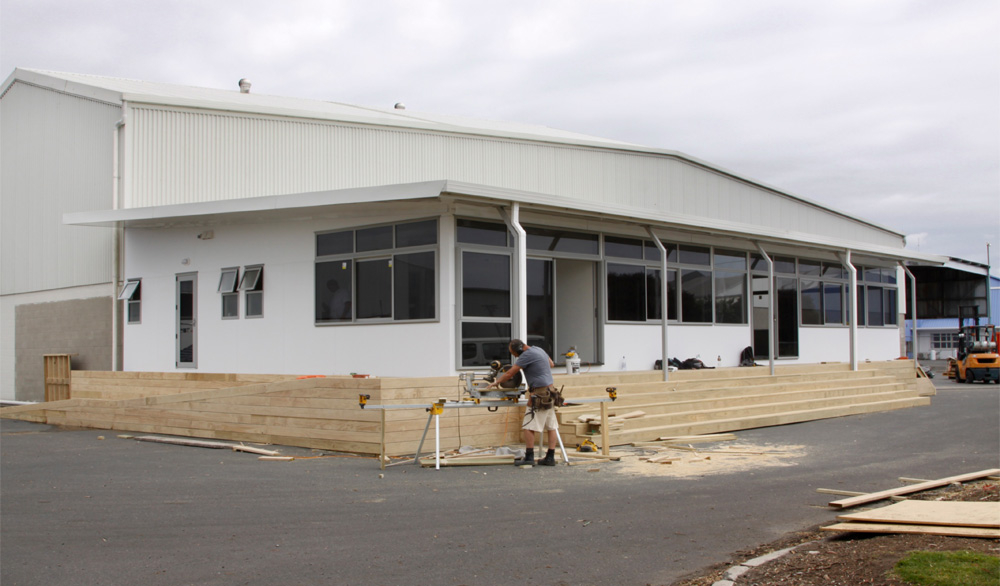

  • Decks being built (image 20)

Week Seven

  • Completion of exterior of building (image 21)

Week Eight

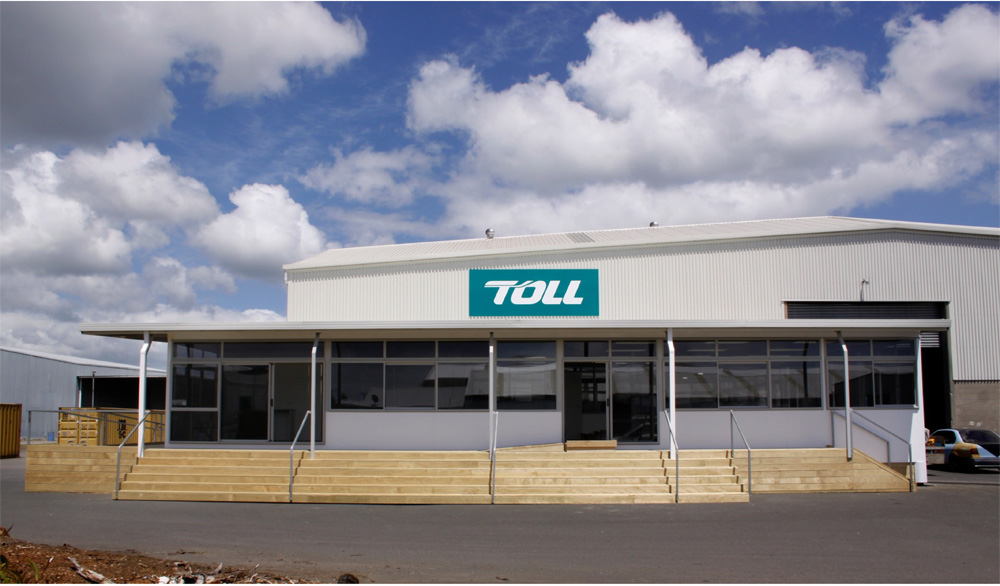

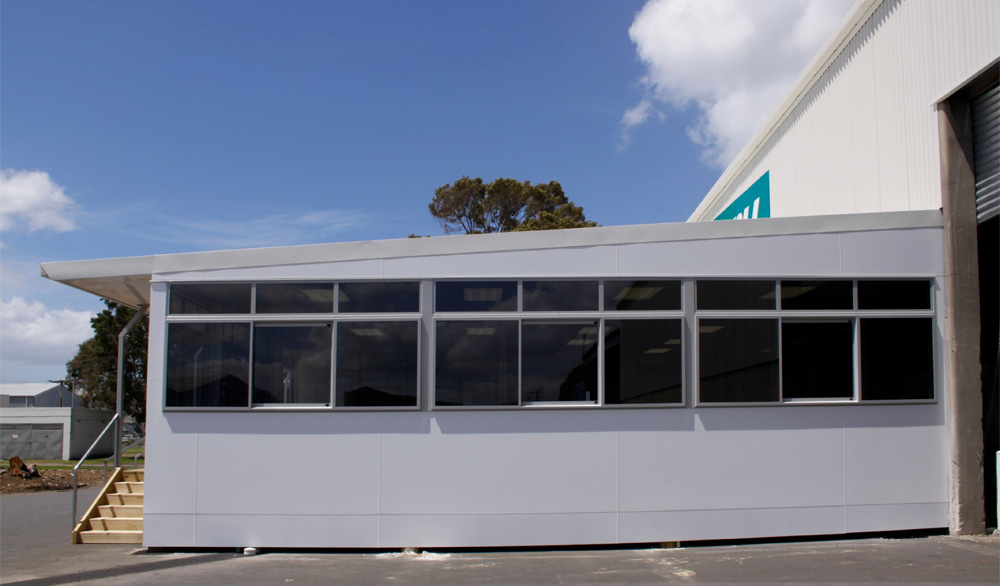

  • Handover over of completed building (images 22-26)

Toll office, tauranga
